Getting started with the MW32x Amazon IoT Starter Kit
Important
This is an archived version of the FreeRTOS User Guide for use with FreeRTOS release 202012.00. For the latest version of this document, see the FreeRTOS User Guide.
The Amazon IoT Starter Kit is a development kit based on the 88MW320/88MW322, the latest integrated Cortex M4
Microcontroller from NXP, that integrates 802.11b/g/n Wi-Fi on a single microcontroller chip. The development kit is
FCC certified. For more information, see the Amazon Partner Device
Catalog
This getting started guide shows you how to cross compile your application together with the SDK on a host computer, then load the generated binary file onto the board using the tools provided with the SDK. When the application starts running on the board, you can debug or interact with it from the Serial console on your host computer.
Ubuntu 16.04 is the host platform supported for development and debugging. You might be able to use other platforms, but these are not officially supported. You must have permissions to install software on the host platform. The following external tools required to build the SDK:
-
Ubuntu 16.04 host platform
-
ARM toolchain version 4_9_2015q3
-
Eclipse 4.9.0 IDE
The ARM toolchain is required to cross compile your application and the SDK. The SDK takes advantage of the latest versions of the toolchain to optimize the image footprint and fit more functionality into less space. This guide assumes that you're using version 4_9_2015q3 of the toolchain. Using older versions of the toolchain isn't recommended. The development kit is pre-flashed with Wireless Microcontroller Demo project firmware.
Topics
Setting up your hardware
Connect the MW32x board to your laptop by using a mini-USB to USB cable. Connect the mini-USB cable to the only mini-USB connector present on the board. You don't need a jumper change.
If the board is connected to a laptop or desktop computer, you don't need an external power supply.
This USB connection provides the following:
-
Console access to the board. A virtual tty/com port is registered with the development host that can be used to access the console.
-
JTAG access to the board. This can be used to load or unload firmware images into the RAM or flash of the board, or for debugging purposes.
Setting up the development environment
For development purposes, the minimum requirement is the ARM toolchain and the tools bundled with the SDK. The following sections provide details on the ARM toolchain setup.
GNU Toolchain
The SDK officially supports the GCC Compiler toolchain. The cross-compiler toolchain for GNU ARM is available
at GNU Arm Embedded Toolchain
4.9-2015-q3-update
The build system is configured to use the GNU toolchain by default. The Makefiles assume that the GNU compiler
toolchain binaries are available on the user's PATH and can be invoked from the Makefiles. The Makefiles also
assume that the file names of the GNU toolchain binaries are prefixed with arm-none-eabi-.
The GCC toolchain can be used with GDB to debug with OpenOCD (bundled with the SDK). This provides the software that interfaces with JTAG.
We recommend version 4_9_2015q3 of the gcc-arm-embedded toolchain.
Linux Toolchain Setup Procedure
Follow these steps to set up the GCC toolchain in Linux.
-
Download the toolchain tarball available at GNU Arm Embedded Toolchain 4.9-2015-q3-update
. The file is gcc-arm-none-eabi-4_9-2015q3-20150921-linux.tar.bz2. -
Copy the file to a directory of your choice. Make sure there are no spaces in the directory name.
-
Use the following command to untar the file.
tar –vxffilename -
Add the path of the installed toolchain to the system PATH. For example, append the following line at the end of the
.profilefile located in/home/directory.user-namePATH=$PATH:path to gcc-arm-none-eabit-4_9_2015_q3/bin
Note
Newer distributions of Ubuntu might come with a Debian version of the GCC Cross Compiler. If so, you must remove the native Cross Compiler and follow the above setup procedure.
Working with a Linux development host
Any modern Linux desktop distribution such as Ubuntu or Fedora can be used. However, we recommend that you upgrade to the most recent release. The following steps have been verified to work on Ubuntu 16.04 and assume that you're using that version.
Installing Packages
The SDK includes a script to enable quick setup of your development environment on a newly setup Linux
machine. The script attempts to auto detect the machine type and install the appropriate software, including
C libraries, USB library, FTDI library, ncurses, python, and latex. In this section, the generic directory
name indicates the Amazon SDK root directory.
The actual directory name might be different. You must have root privileges.amzsdk_bundle-x.y.z
-
Navigate to the
directory and run this command.amzsdk_bundle-x.y.z/./lib/third_party/mcu_vendor/marvell/WMSDK/mw320/sdk/tools/bin/installpkgs.sh
Avoiding sudo
In this guide, the flashprog operation uses the flashprog.py script to flash
the NAND of the board, as explained below. Similarly, the ramload operation uses the
ramload.py script to copy the firmware image from the host directly to the RAM of the
microcontroller, without flashing the NAND.
You can configure your Linux development host to perform the flashprog and ramload
operations without requiring the sudo command each time. To do this, run the following
command.
./lib/third_party/mcu_vendor/marvell/WMSDK/mw320/sdk/tools/bin/perm_fix.sh
Note
You must configure your Linux development host permissions in this way to ensure a smooth Eclipse IDE experience.
Setting up the Serial Console
Insert the USB cable into the Linux host USB slot. This triggers the detection of the device. You should
see messages like the following in the /var/log/messages file, or after executing the
dmesg command.
Jan 6 20:00:51 localhost kernel: usb 4-2: new full speed USB device using uhci_hcd and address 127 Jan 6 20:00:51 localhost kernel: usb 4-2: configuration #1 chosen from 1 choice Jan 6 20:00:51 localhost kernel: ftdi_sio 4-2:1.0: FTDI USB Serial Device converter detected Jan 6 20:00:51 localhost kernel: ftdi_sio: Detected FT2232C Jan 6 20:00:51 localhost kernel: usb 4-2: FTDI USB Serial Device converter now attached to ttyUSB0 Jan 6 20:00:51 localhost kernel: ftdi_sio 4-2:1.1: FTDI USB Serial Device converter detected Jan 6 20:00:51 localhost kernel: ftdi_sio: Detected FT2232C Jan 6 20:00:51 localhost kernel: usb 4-2: FTDI USB Serial Device converter now attached to ttyUSB1
Verify that two ttyUSB devices have been created. The second ttyUSB is the serial console. In the example above, this is named "ttyUSB1".
In this guide, we use minicom to see the serial console output. You might also use other serial programs
such as putty. Run the following command to execute minicom in setup mode.
minicom –s
In minicom, navigate to Serial Port Setup and capture the following settings.
| A - Serial Device : /dev/ttyUSB1 | B – Lockfile Location : /var/lock | C - Callin Program : | D - Callout Program : | E - Bps/Par/Bits : 115200 8N1 | F – Hardware Flow Control : No | G – Software Flow Control : No
You can save these settings in minicom for future use. The minicom window now shows messages from the serial console.
Choose the serial console window and press the Enter key. This displays a hash (#) on the screen.
Note
The development boards include an FTDI silicon device. The FTDI device exposes two USB interfaces for the host. The first interface is associated with the JTAG functionality of the MCU and the second interface is associated with the physical UARTx port of the MCU.
Installing OpenOCD
OpenOCD is software that provides debugging, in-system programming, and boundary-scan testing for embedded target devices.
OpenOCD version 0.9 is required. It's also required for Eclipse functionality. If an earlier version, such as version 0.7, was installed on your Linux host, remove that repository with the appropriate command for the Linux distribution that you're currently using.
Run the standard Linux command to install OpenOCD,
apt-get install openocd
If the above command doesn't install version 0.9 or later, use the following procedure to download and compile the openocd source code.
To install OpenOCD
-
Run the following command to install libusb-1.0.
sudo apt-get install libusb-1.0 -
Download the openocd 0.9.0 source code from http://openocd.org/
. -
Extract openocd and navigate to the directory where you extracted it.
-
Configure openocd with the following command.
./configure --enable-ftdi --enable-jlink -
Run the make utility to compile opencd.
make install
Setting up Eclipse
Note
This section assumes that you have completed the steps in Avoiding sudo
Eclipse is the preferred IDE for application development and debugging. It provides a rich, user-friendly IDE with integrated debugging support, including thread aware debugging. This section describes the common Eclipse setup for all the development hosts that are supported.
To set up Eclipse
-
Download and install the Java Run Time Environment (JRE).
Eclipse requires that you install the JRE. We recommend that you install this first, although it can be installed after you install Eclipse. The JRE version (32/64 bit) must match the version of Eclipse (32/64 bit). You can download the JRE from Java SE Runtime Environment 8 Downloads
on the Oracle website. -
Download and install the "Eclipse IDE for C/C++ Developers" from http://www.eclipse.org
. Eclipse version 4.9.0 or later is supported. The installation only requires you to extract the downloaded archive. You run the platform-specific Eclipse executable to start the application.
Build and run the FreeRTOS demo project
There are two ways to run the FreeRTOS demo project:
-
Use the command line.
-
Use the Eclipse IDE.
This topic covers both options.
Provisioning
-
Depending on whether you use the test or demo application, set the provisioning data in one of the following files:
-
./tests/common/include/aws_clientcredential.h -
./demos/common/include/aws_clientcredential.h
For example:
#define clientcredentialWIFI_SSID "Wi-Fi SSID" #define clientcredentialWIFI_PASSWORD "Wi-Fi password" #define clientcredentialWIFI_SECURITY "Wi-Fi security"Note
You can enter the following Wi-Fi security values:
eWiFiSecurityOpeneWiFiSecurityWEPeWiFiSecurityWPAeWiFiSecurityWPA2
The SSID and password should be enclosed in double quotes.
-
Build and run the FreeRTOS demo using the command line
-
Use the following command to start building the demo application.

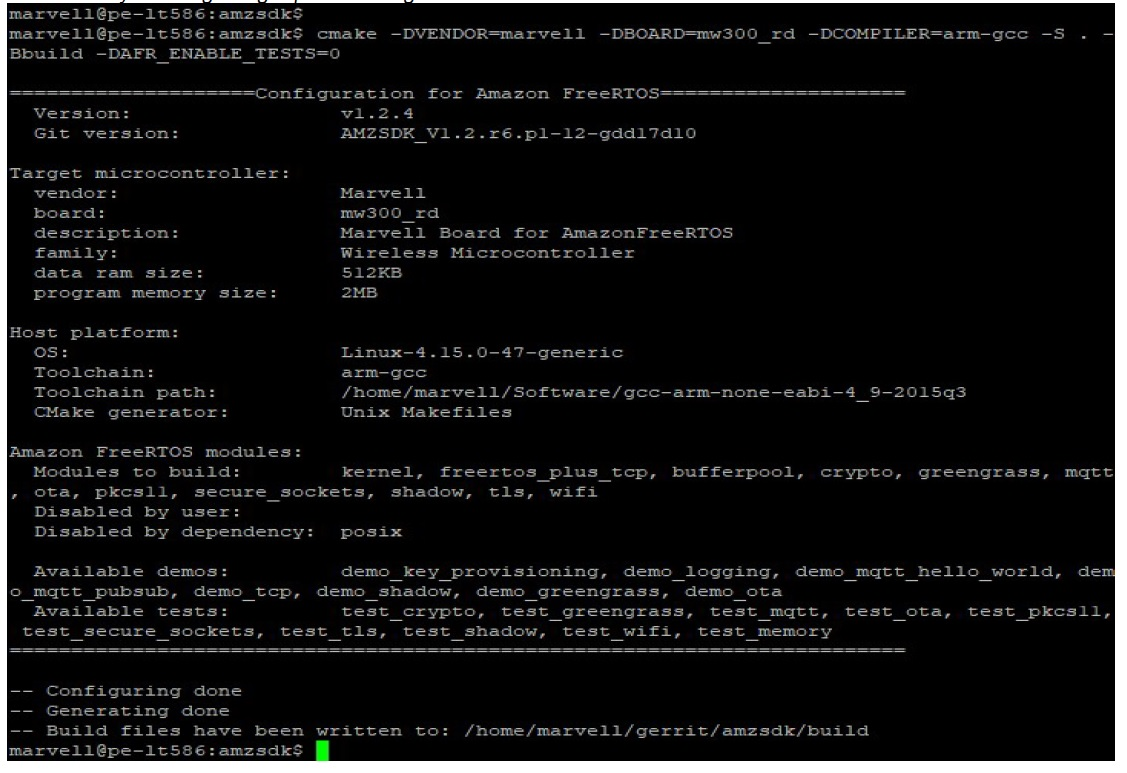

cmake -DVENDOR=marvell -DBOARD=mw320 -DCOMPILER=arm-gcc -S . -Bbuild -DAFR_ENABLE_TESTS=0Make sure you get the same output as shown in the following example.
-
Navigate to the build directory.
cd build -
Run the make utility to build the application.

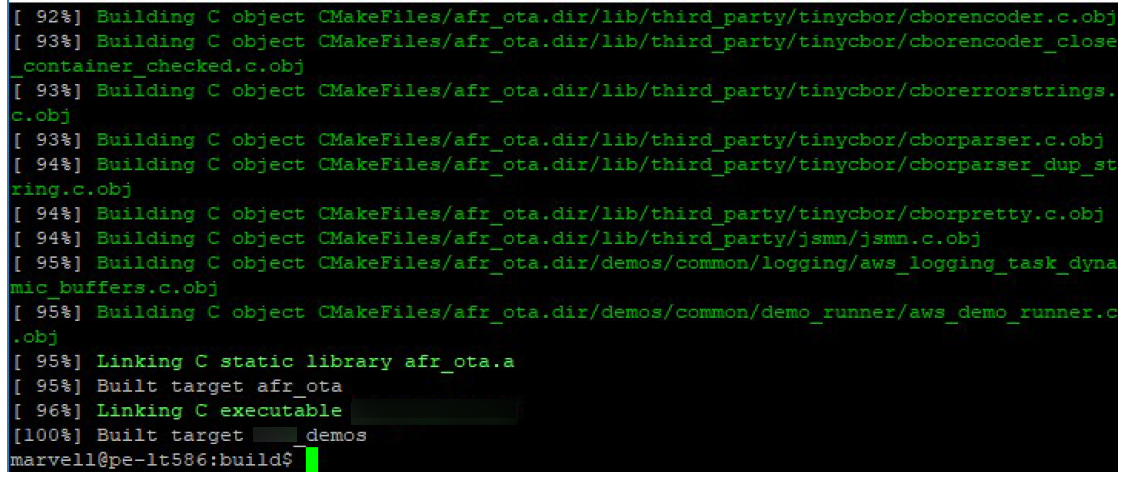

make all -j4Make sure you get the same output as shown in the following figure:
-
Use the following commands to build a test application.
cmake -DVENDOR=marvell -DBOARD=mw320 -DCOMPILER=arm-gcc -S . -Bbuild -DAFR_ENABLE_TESTS=1 cd build make all -j4Run the
cmakecommand every time you switch between theaws_demos projectand theaws_tests project. -
Write the firmware image to the flash of the development board. The firmware will execute after the development board is reset. You must build the SDK before you flash the image to the microcontroller.
-
Before you flash the firmware image, prepare the development board's flash with the common components Layout and Boot2. Use the following commands.

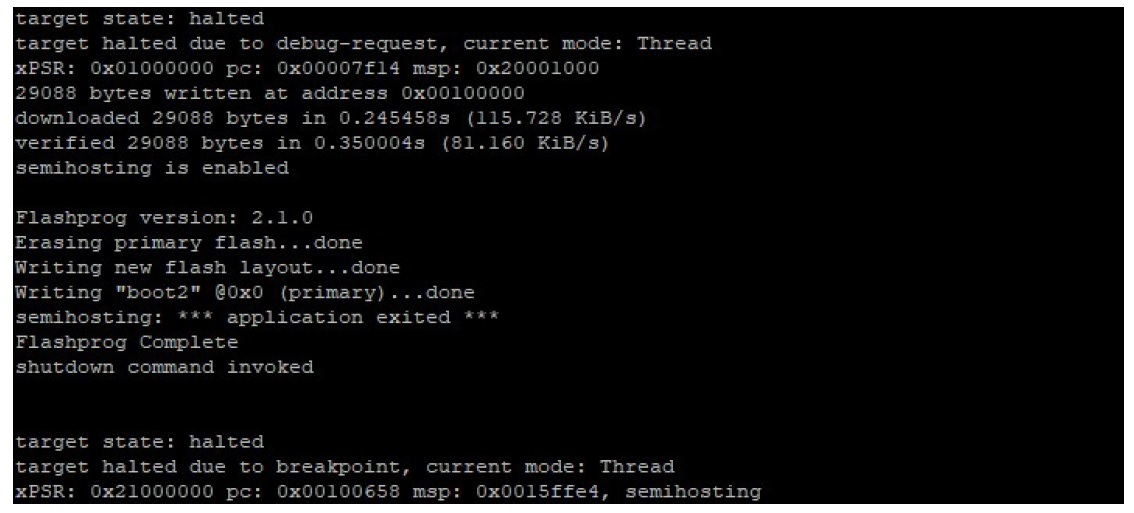

cd amzsdk_bundle-x.y.z ./vendors/marvell/WMSDK/mw320/sdk/tools/OpenOCD/flashprog.py -l ./vendors/marvell/WMSDK/mw320/sdk/tools/OpenOCD/mw300/layout.txt --boot2 ./vendors/marvell/WMSDK/mw320/boot2/bin/boot2.binThe
flashprogcommand initiates the following:-
Layout – The flashprog utility is first instructed to write a layout to the flash. The layout is similar to partition information for the flash. The default layout is located at
/lib/third_party/mcu_vendor/marvell/WMSDK/mw320/sdk/tools/OpenOCD/mw300/layout.txt. -
Boot2 – This is the boot-loader used by the WMSDK. The
flashprogcommand also writes a bootloader to the flash. It's the bootloader's job to load the microcontroller's firmware image after it's flashed. Make sure you get the same output as shown in the figure below.
-
-

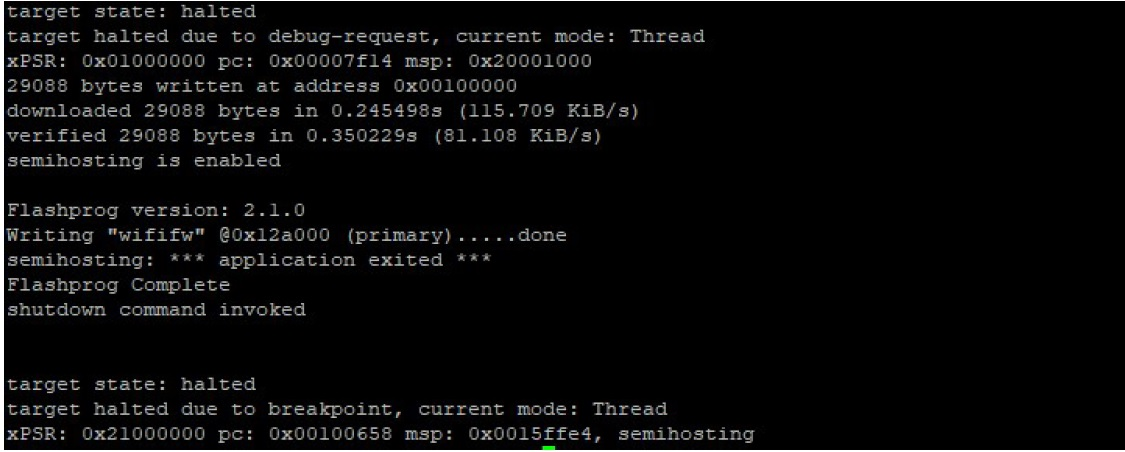

The firmware uses the Wi-Fi chipset for its functionality, and the Wi-Fi chipset has its own firmware that must also be present in the flash. You use the
flashprog.pyutility to flash the Wi-Fi firmware in the same way that you did to flash the Boot2 boot-loader and the MCU firmware. Use the following commands to flash the Wi-Fi firmware.cd amzsdk_bundle-x.y.z ./vendors/marvell/WMSDK/mw320/sdk/tools/OpenOCD/flashprog.py --wififw ./vendors/marvell/WMSDK/mw320/wifi-firmware/mw30x/mw30x_uapsta_W14.88.36.p135.binMake sure the output of the command is similar to the figure below.
-
Use the following commands to flash the MCU firmware.
cd amzsdk_bundle-x.y.z ./vendors/marvell/WMSDK/mw320/sdk/tools/OpenOCD/flashprog.py --mcufw build/cmake/vendors/marvell/mw300_rd/aws_demos.bin -r -
Reset the board. You should see the logs for the demo app.
-
To run the test app, flash the
aws_tests.binbinary located at the same directory.cd amzsdk_bundle-x.y.z ./vendors/marvell/WMSDK/mw320/sdk/tools/OpenOCD/flashprog.py --mcufw build/cmake/vendors/marvell/mw300_rd/aws_tests.bin -rYour command output should be similar to the one shown in the figure below.
-
-

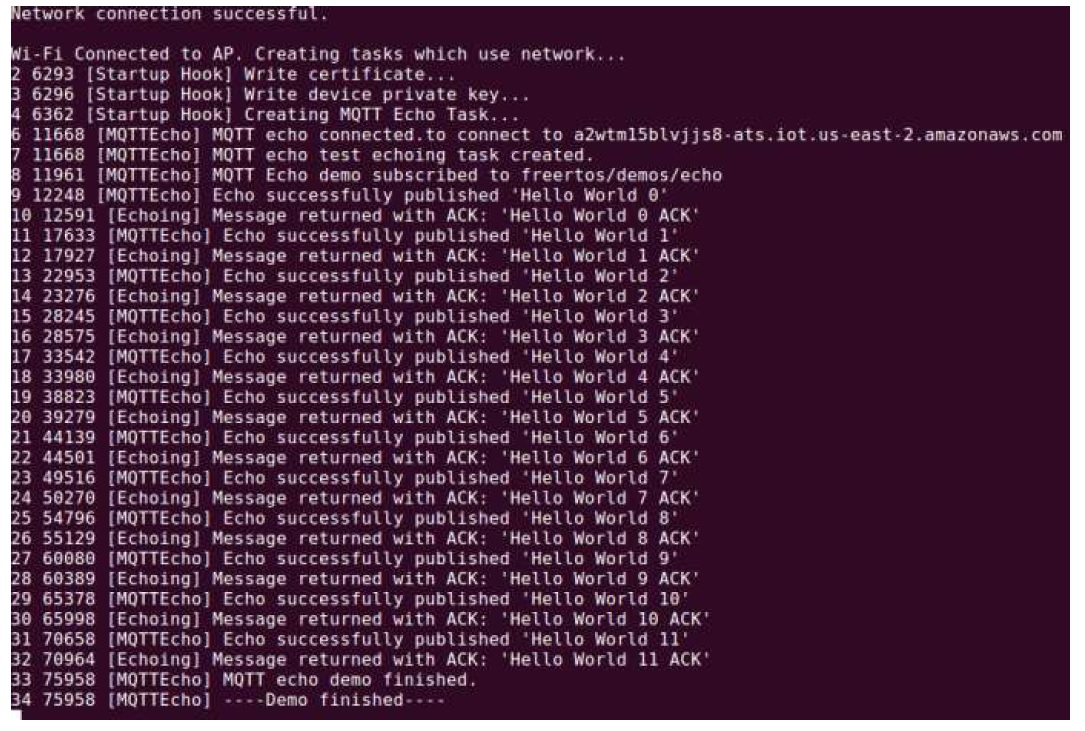

After you flash the firmware and reset the board, the demo app should start as shown in the figure below.
-
(Optional) As an alternative method to test your image, use the flashprog utility to copy the microcontroller image from the host directly into the microcontroller RAM. The image isn't copied in the flash, so it will be lost after you reboot the microcontroller.
Loading the firmware image into the SRAM is a faster operation because it launches the execution file immediately. This method is used primarily for iterative development.
Use the following commands to load the firmware into the SRAM.

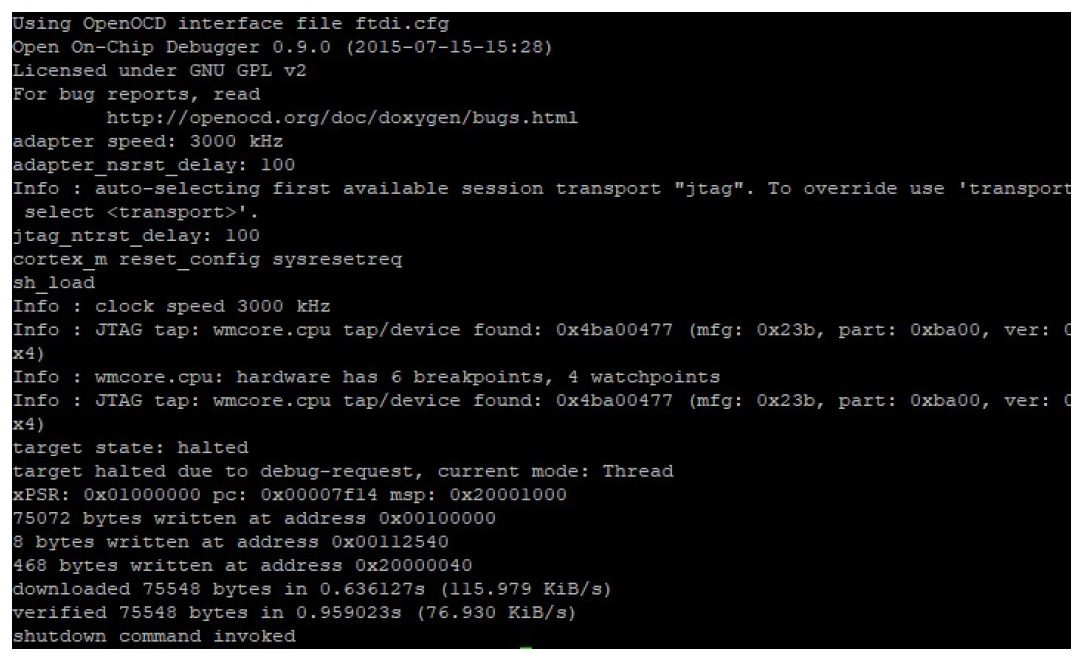

cd amzsdk_bundle-x.y.z ./lib/third_party/mcu_vendor/marvell/WMSDK/mw320/sdk/tools/OpenOCD/ramload.py build/cmake/vendors/marvell/mw300_rd/aws_demos.axfThe command output is shown in the figure below.
When the command execution is complete, you should see the logs of the demo app.
Build and run the FreeRTOS demo using the Eclipse IDE
-
Before you set up an Eclipse workspace, you must run the
cmakecommand.Run the following command to work with the
aws_demosEclipse project.cmake -DVENDOR=marvell -DBOARD=mw320 -DCOMPILER=arm-gcc -S . -Bbuild -DAFR_ENABLE_TESTS=0Run the following command to work with the
aws_testsEclipse project.cmake -DVENDOR=marvell -DBOARD=mw320 -DCOMPILER=arm-gcc -S . -Bbuild -DAFR_ENABLE_TESTS=1Tip
Run the
cmakecommand every time you switch between theaws_demosproject and theaws_testsproject. -

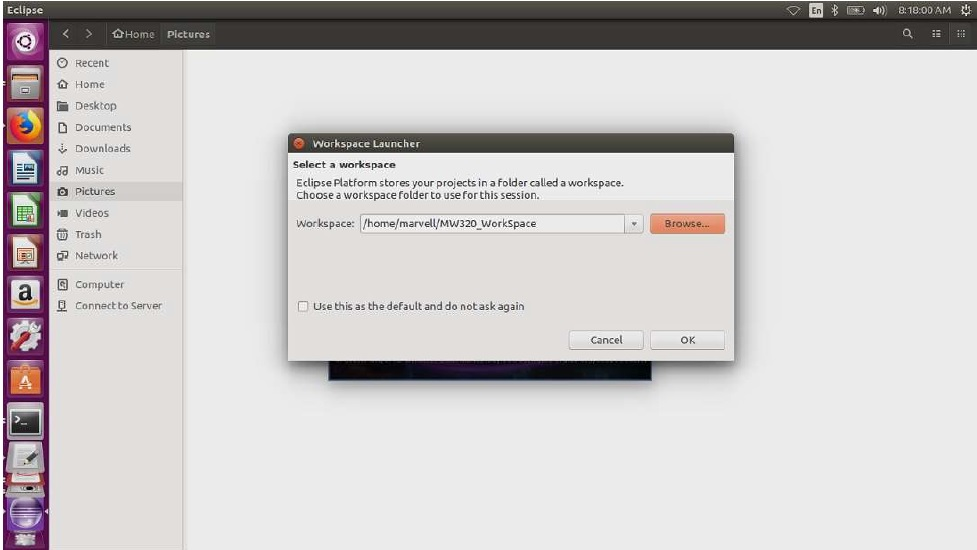

Open Eclipse and, when prompted, choose your Eclipse workspace as shown in the figure below.
-

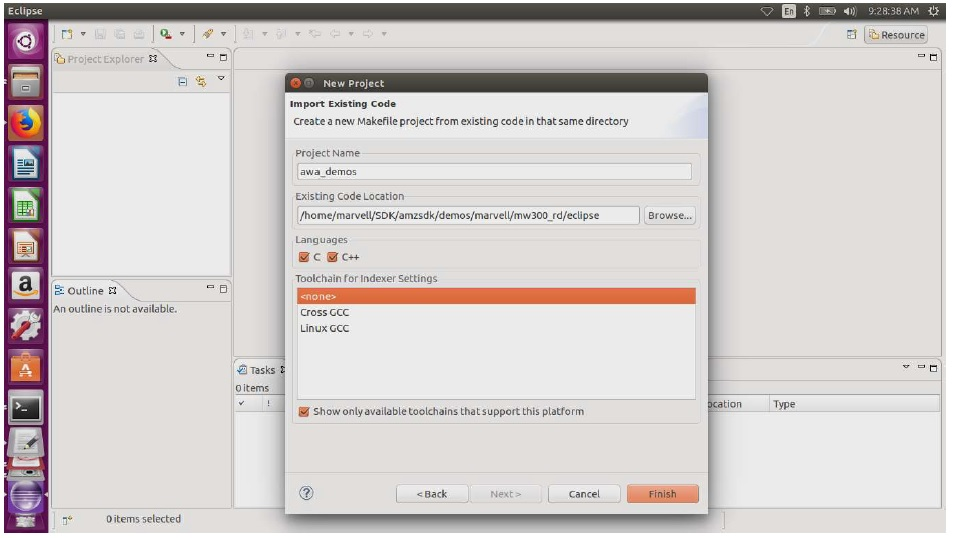

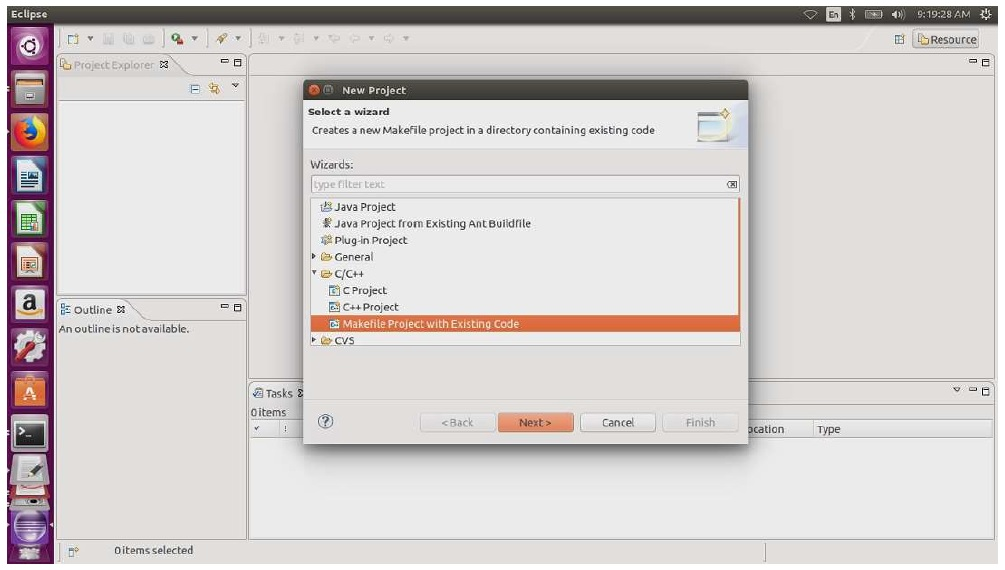

Choose the option to create a Makefile Project: with Existing Code as shown in the figure below.
-
Choose Browse, specify the directory of the existing code, and then choose Finish.
-

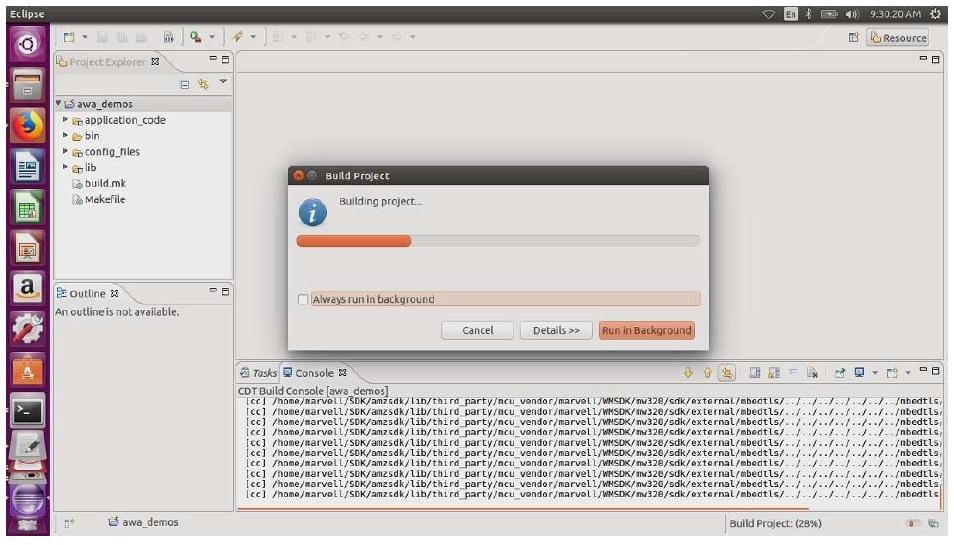

In the navigation pane, choose aws_demos in the project explorer. Right-click aws_demos to open the menu, then choose Build.
If the build succeeds, it generates the
build/cmake/vendors/marvell/mw300_rd/aws_demos.binfile. -
Use the command line tools to flash the Layout file (
layout.txt), the Boot2 binary (boot2.bin), the MCU firmware binary (aws_demos.bin), and the Wi-Fi firmware.-
Before you flash the firmware image, prepare the development board's flash with the common components, Layout and Boot2. Use the following commands.
cd amzsdk_bundle-x.y.z ./vendors/marvell/WMSDK/mw320/sdk/tools/OpenOCD/flashprog.py -l ./vendors/marvell/WMSDK/mw320/sdk/tools/OpenOCD/mw300/layout.txt --boot2 ./vendors/marvell/WMSDK/mw320/boot2/bin/boot2.binThe
flashprogcommand initiates the following:-
Layout – The flashprog utility is first instructed to write a layout to the flash. The layout is similar to partition information for the flash. The default layout is located at
/lib/third_party/mcu_vendor/marvell/WMSDK/mw320/sdk/tools/OpenOCD/mw300/layout.txt. -
Boot2 – This is the boot-loader used by the WMSDK. The flashprog command also writes a bootloader to the flash. It is the bootloader's job to load the microcontroller's firmware image after it is flashed. Make sure you get the same output as shown in the figure below.
-
-
The firmware uses the Wi-Fi chipset for its functionality, and the Wi-Fi chipset has its own firmware that must also be present in the flash. You use the
flashprog.pyutility to flash the Wi-Fi firmware in the same way that you did to flash the boot2 boot-loader and the MCU firmware. Use the following commands to flash the Wi-Fi firmware.cd amzsdk_bundle-x.y.z ./vendors/marvell/WMSDK/mw320/sdk/tools/OpenOCD/flashprog.py --wififw ./vendors/marvell/WMSDK/mw320/wifi-firmware/mw30x/mw30x_uapsta_W14.88.36.p135.binMake sure the output of the command is similar to the figure below.
-
Use the following commands to flash the MCU firmware.

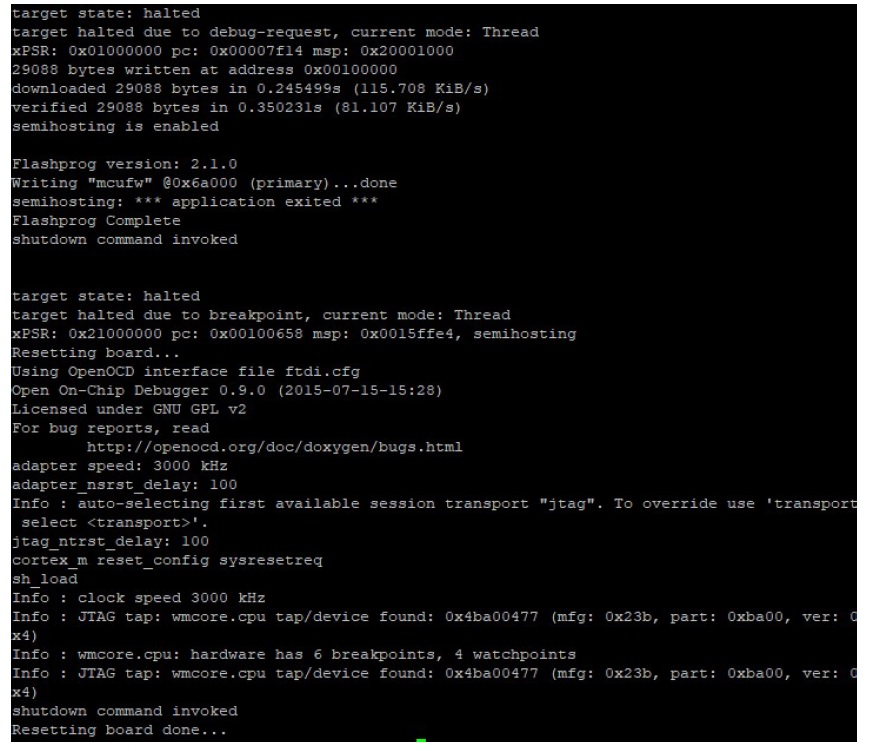

cd amzsdk_bundle-x.y.z ./vendors/marvell/WMSDK/mw320/sdk/tools/OpenOCD/flashprog.py --mcufw build/cmake/vendors/marvell/mw300_rd/aws_demos.bin -r -
Reset the board. You should see the logs for the demo app.
-
To run the test app, flash the
aws_tests.binbinary located at the same directory.cd amzsdk_bundle-x.y.z ./vendors/marvell/WMSDK/mw320/sdk/tools/OpenOCD/flashprog.py --mcufw build/cmake/vendors/marvell/mw300_rd/aws_tests.bin -rYour command output should be similar to the one shown in the figure below.
-
Debugging
-

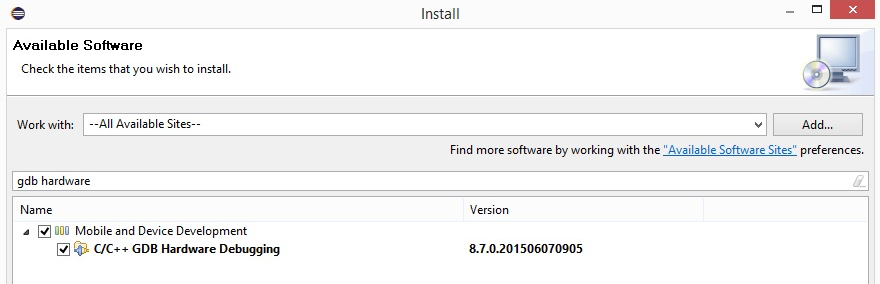

Start Eclipse and choose Help and then choose Install new software. In the Work with menu, choose All Available Sites. Enter the filter text
GDB Hardware. Select the C/C++ GDB Hardware Debugging option and install the plugin.
Troubleshooting
- Network issues
-
Check your network credentials. See "Provisioning" in Build and run the FreeRTOS demo project.
- Enabling additional logs
-
-
Enable board specific logs.
Enable calls to
wmstdio_init(UART0_ID, 0)in the functionprvMiscInitializationin themain.cfile for tests or demos. -
Enabling Wi-Fi logs
Enable the macro
CONFIG_WLCMGR_DEBUGin thefile.freertos/vendors/marvell/WMSDK/mw320/sdk/src/incl/autoconf.h
-
- Using GDB
-
We recommend that you use the
arm-none-eabi-gdbandgdbcommand files packaged along with the SDK. Navigate to the directory.cdfreertos/lib/third_party/mcu_vendor/marvell/WMSDK/mw320Run the following command (on a single line) to connect to GDB.
arm-none-eabi-gdb -x ./sdk/tools/OpenOCD/gdbinit ../../../../../../build/cmake/vendors/marvell/mw300 _rd/aws_demos.axf
